    Road and civil engineering

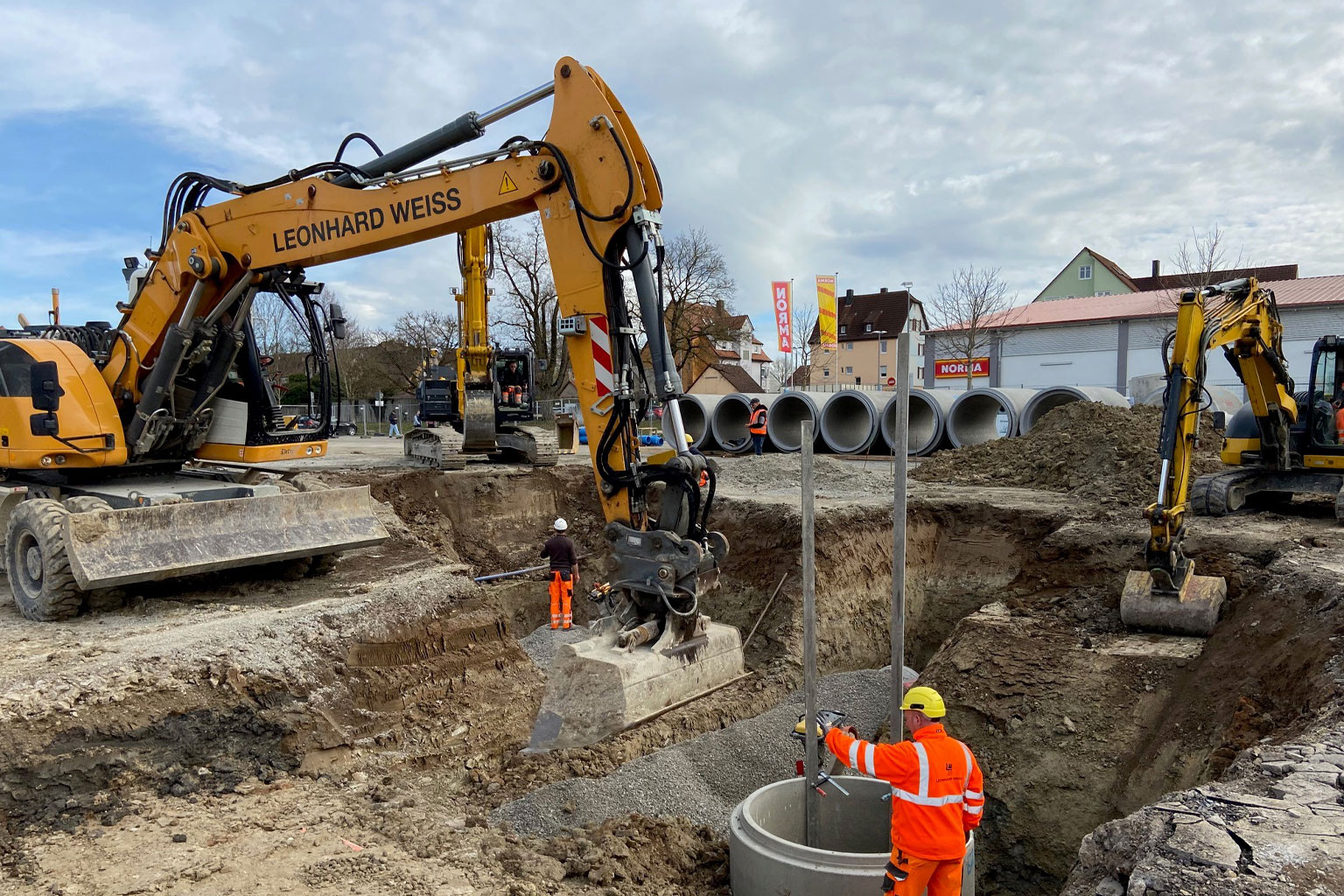

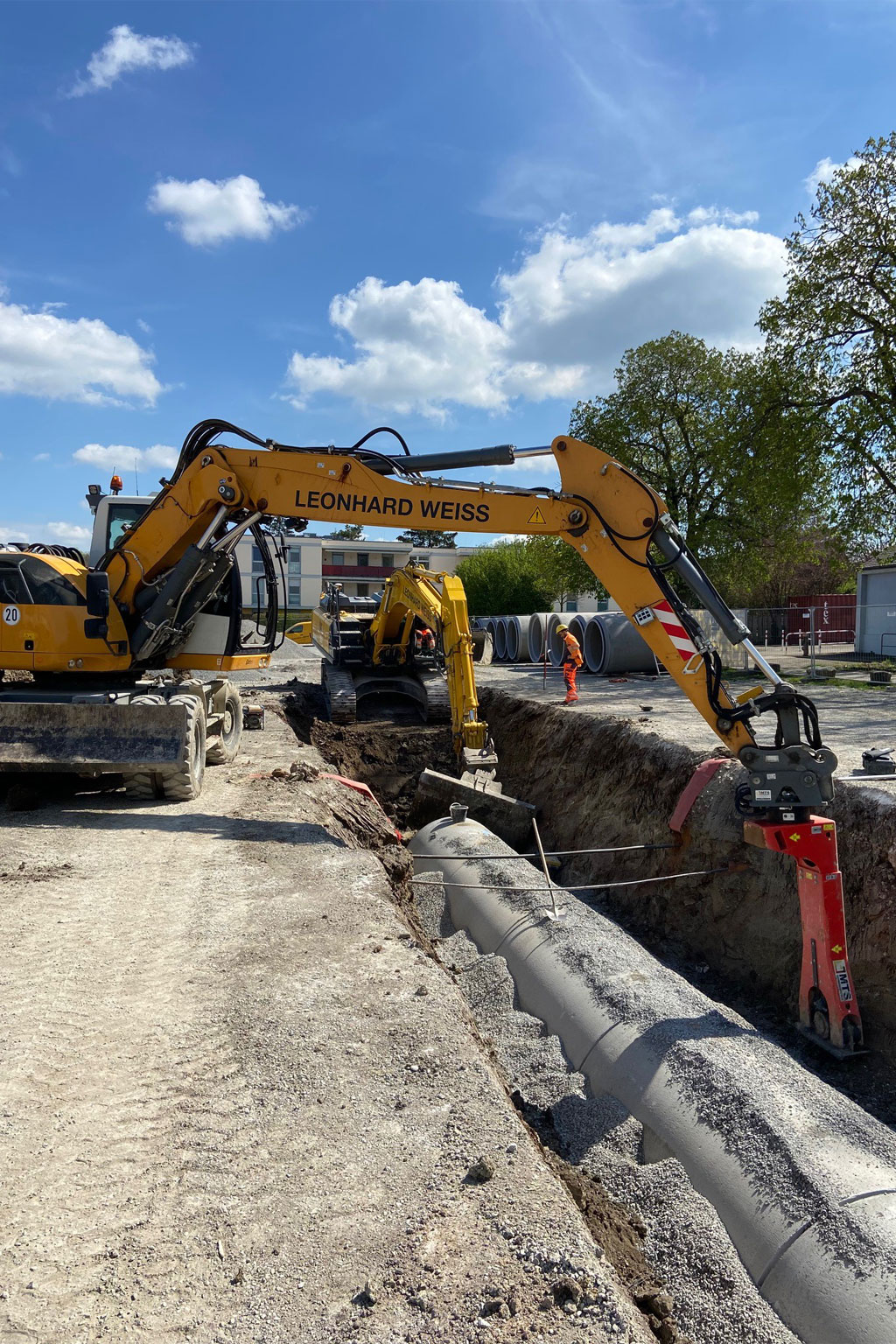

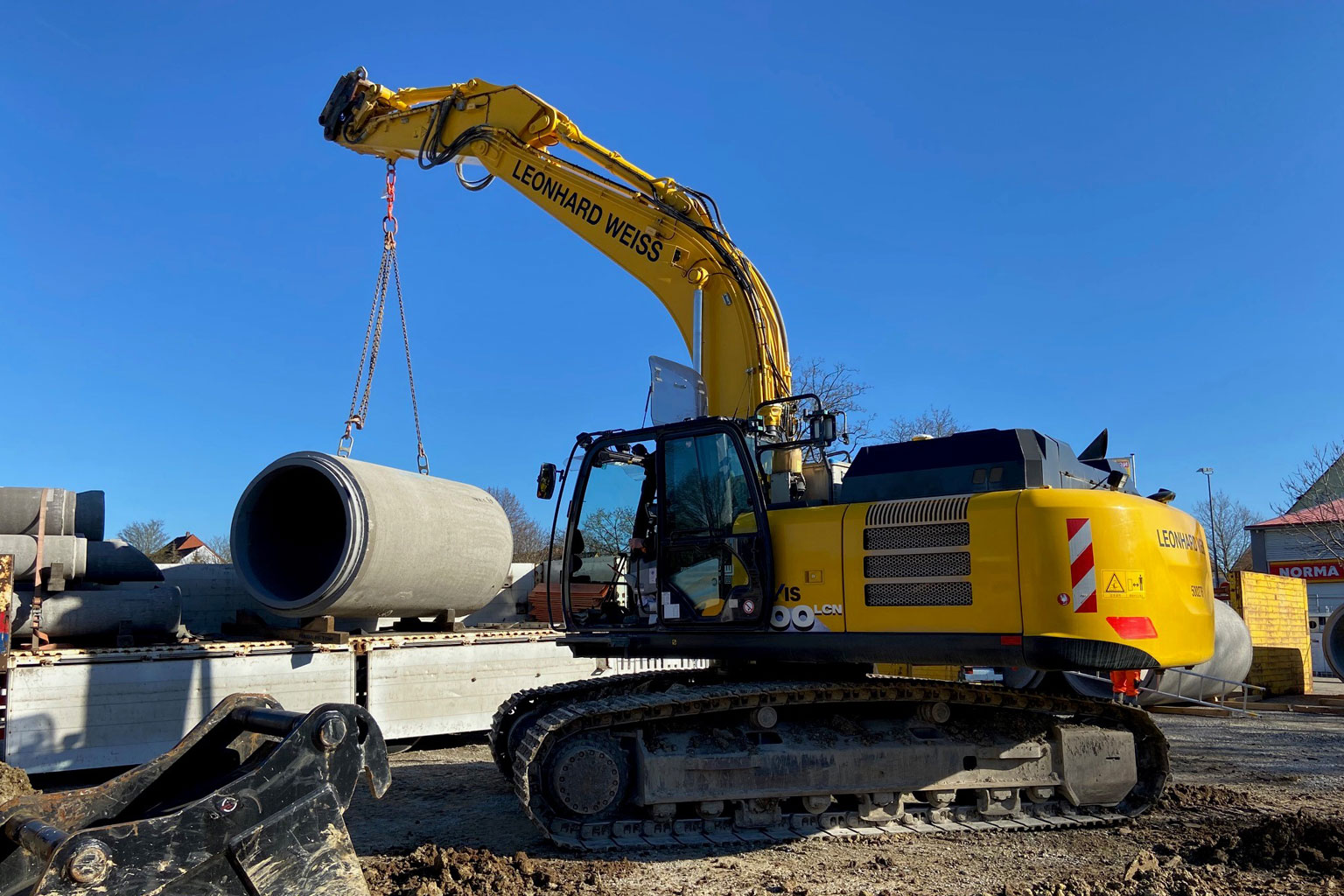

Crailsheim, renovation area Östliche Innenstadt (Volksfestplatz), sewer construction

Customer: Stadt Crailsheim
Construction period: 6 months Year of construction: 2022–2023
Removal of asphalt (up to 20 cm) and renovation (8 cm) approx. 1,100 m²
Installation of ballast bearing layers approx. 1,800 m³
Excavation of pipe trenches approx. 10,400 m³
Backfilling of trenches approx. 3,500 m³
Installation of pipes DN 250-300 polypropylene approx. 320 m
Installation of pipes DN 400-600 reinforced concrete pipe approx. 450 m
Installation of pipes DN 400-600 reinforced concrete pipe approx. 140 m
Installation of pipes DN 1500 reinforced concrete pipe approx. 406 m
Manholes DN 1000 – 1500 reinforced concrete pipe up to 4 m of depth 27 pcs.
Tangential sewers reinforced concrete pipe DN1500 12 pcs.
Laying of culverts under gas and water pipes

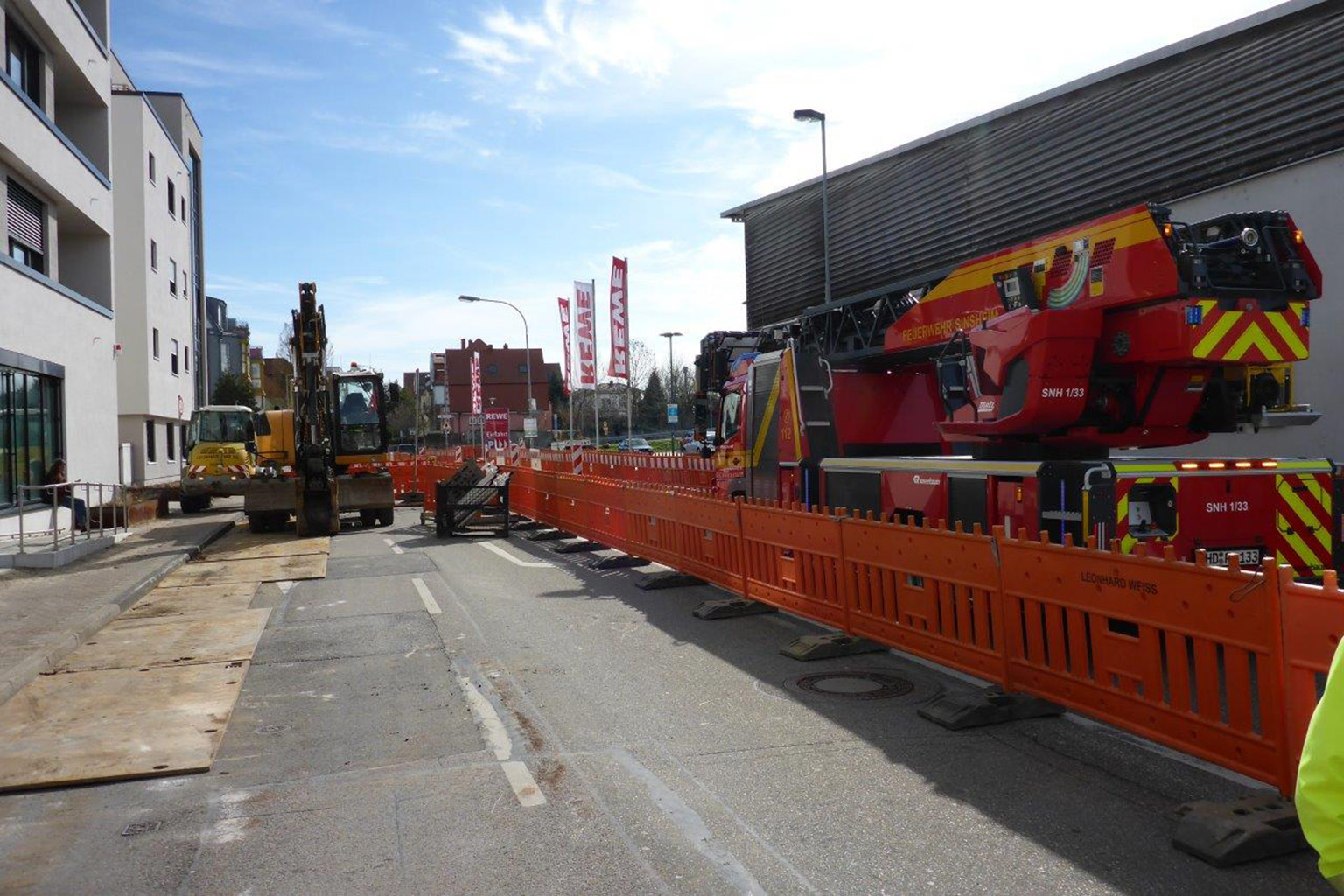

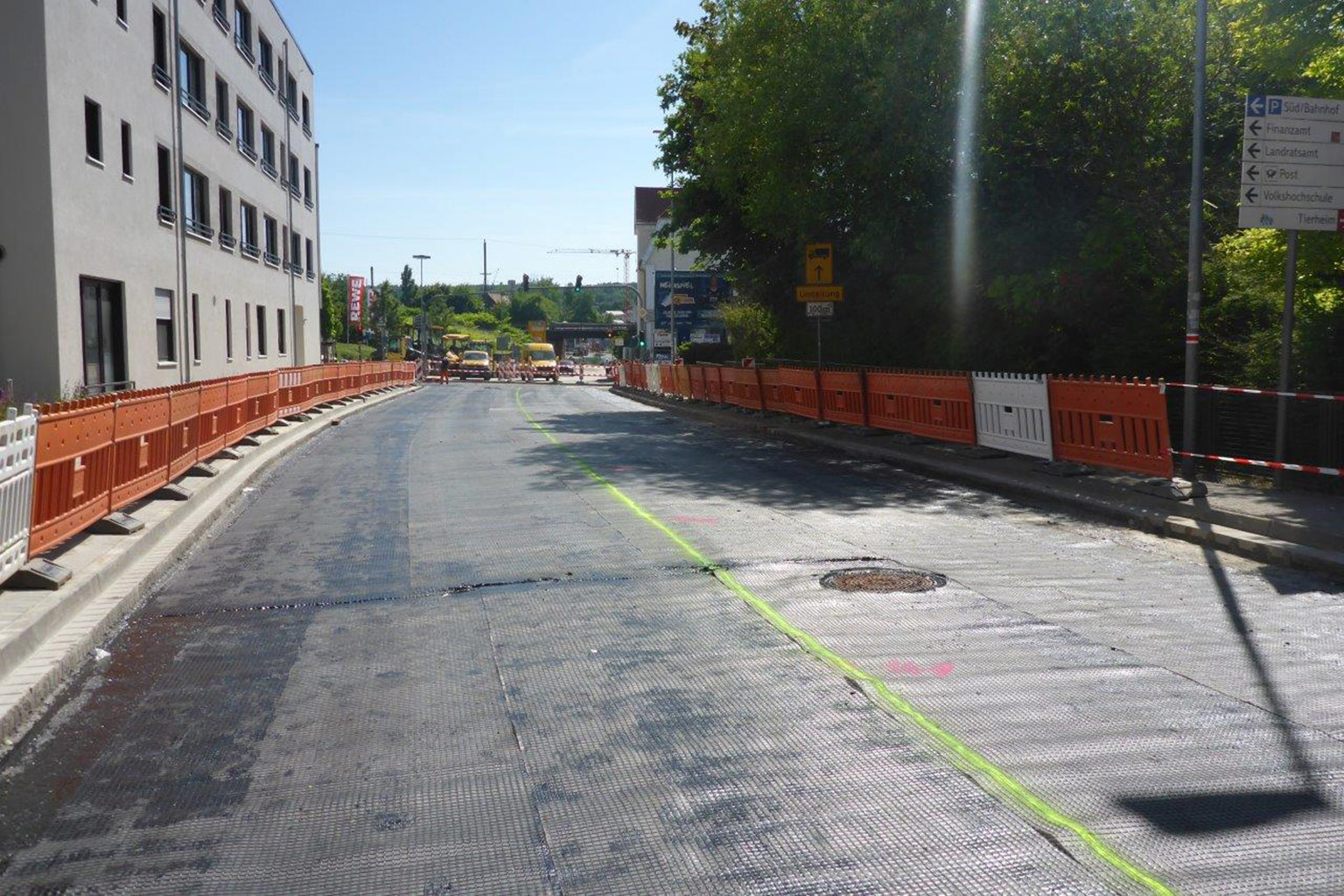

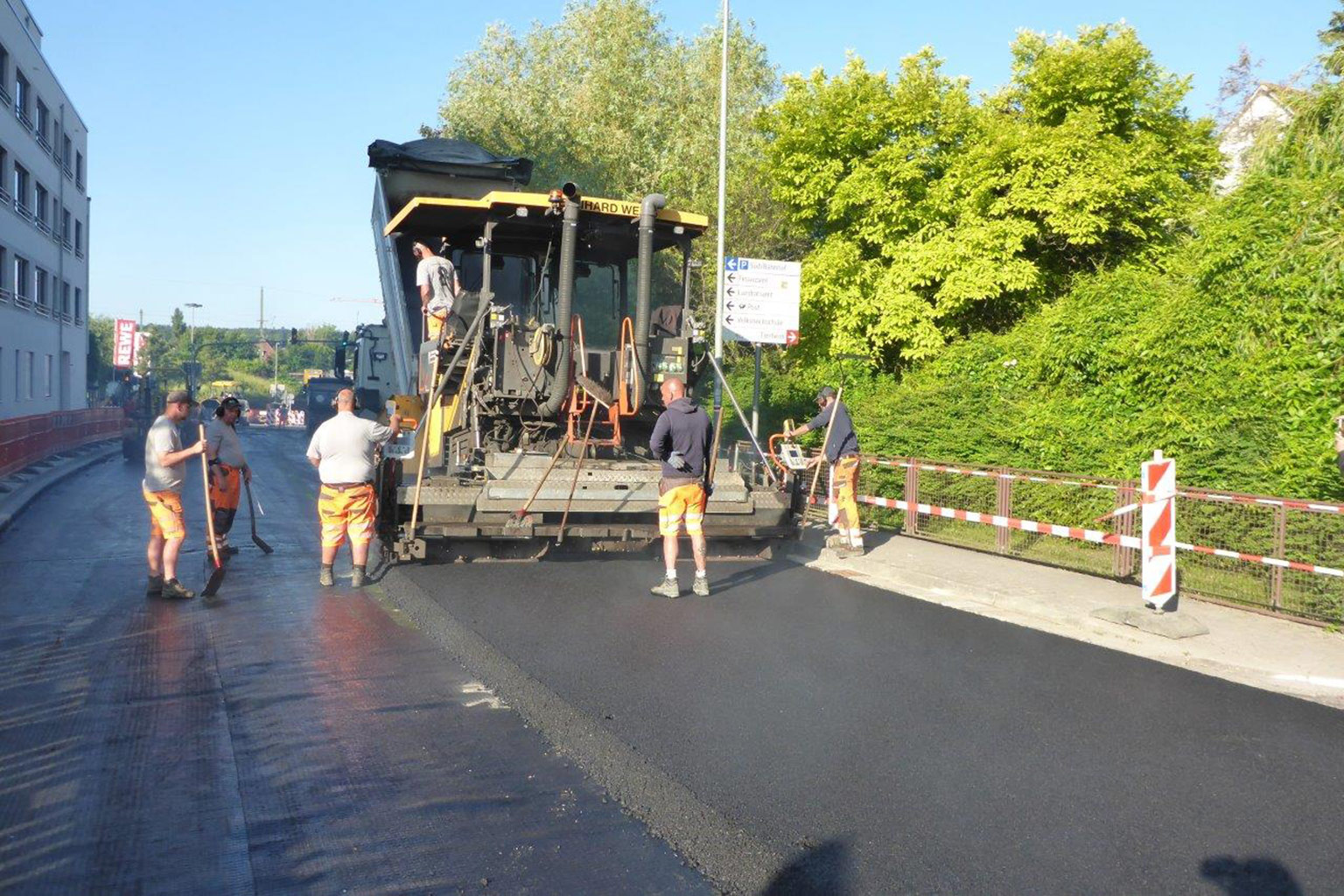

Sinsheim – renovation Dührener Straße and Muthstraße

Customer: Stadt Sinsheim
Construction period: 8 months Year of construction: 2022–2023
4 traffic phases in the area of the inner city with supra-local road signs
110 m construction of freshwater pipe made of ductile cast iron with bend anchors
4 m thermally insulated cast pipe with installation to existing bridge
1,900 m² milling of asphalt surface layer
1,900 m² milling of asphalt binder layer
470 m temporary storage and disposal of asphalt milling material
3,800 m² installation of contact adhesive
875 m² installation of asphalt bearing layer
1,900 m² installation of asphalt binder layer
1,900 m² installation of asphalt top layer
1,000 m² installation of asphalt reinforcement
33 installation of construction parts at the correct height

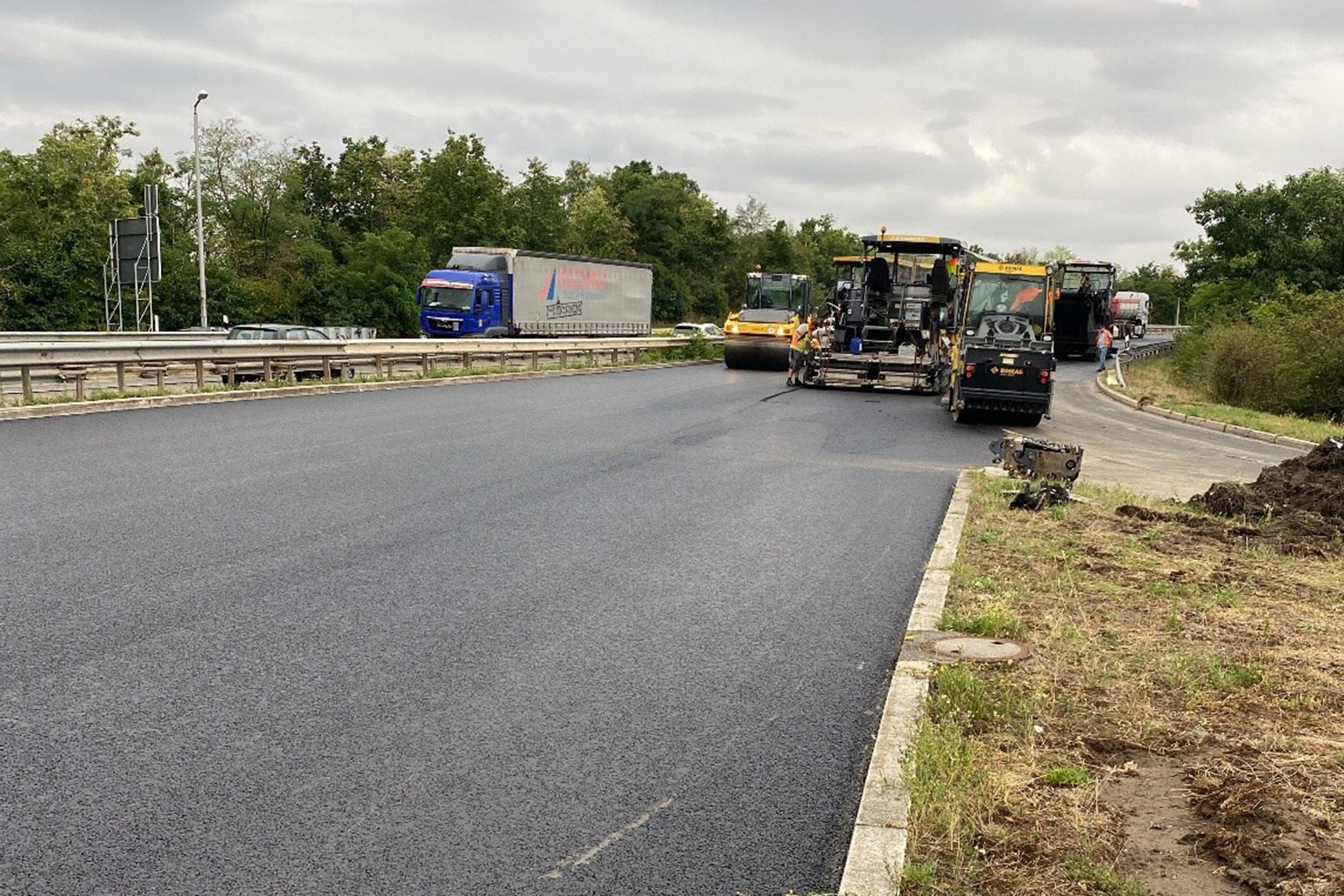

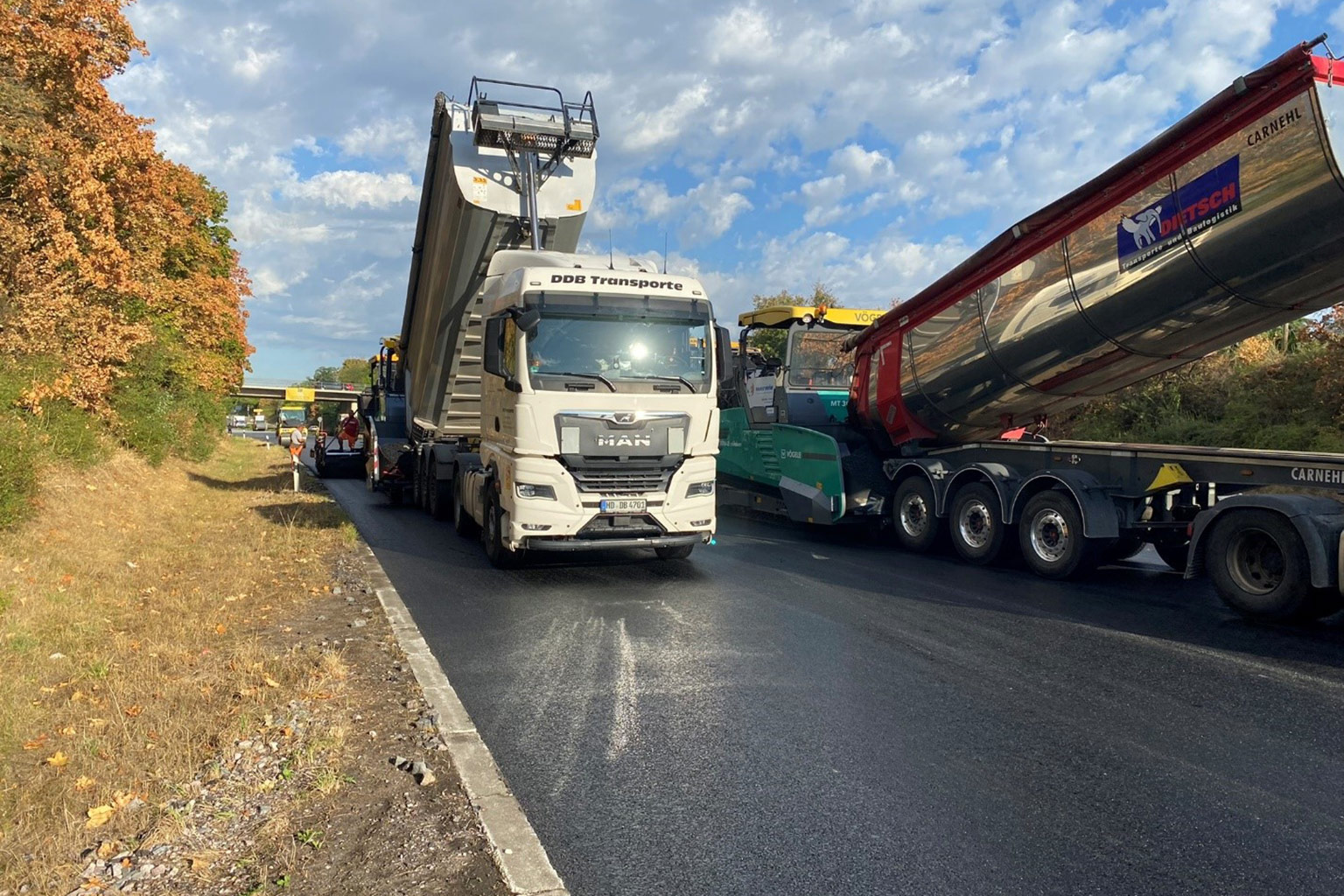

B 36 FDE Mannheim-Rhein to Schwetzingen

Customer: RP Karlsruhe
Construction period: 5 months Year of construction: 2022
13.000 m² inspection for warfare material
2,650 m temporary marking
5,200 m milling of shoulder and reconstruction
3,200 m² profiling of sublayer
19,500 m cutting of base course
77,000 m² milling of asphalt
3,200 m² removal of bituminous stabilisation
81,000 m² installation of asphalt (sublayer, binder layer and top layer)
10,000 m production of asphalt joints
5,200 m production of seals
16,600 m production of marking

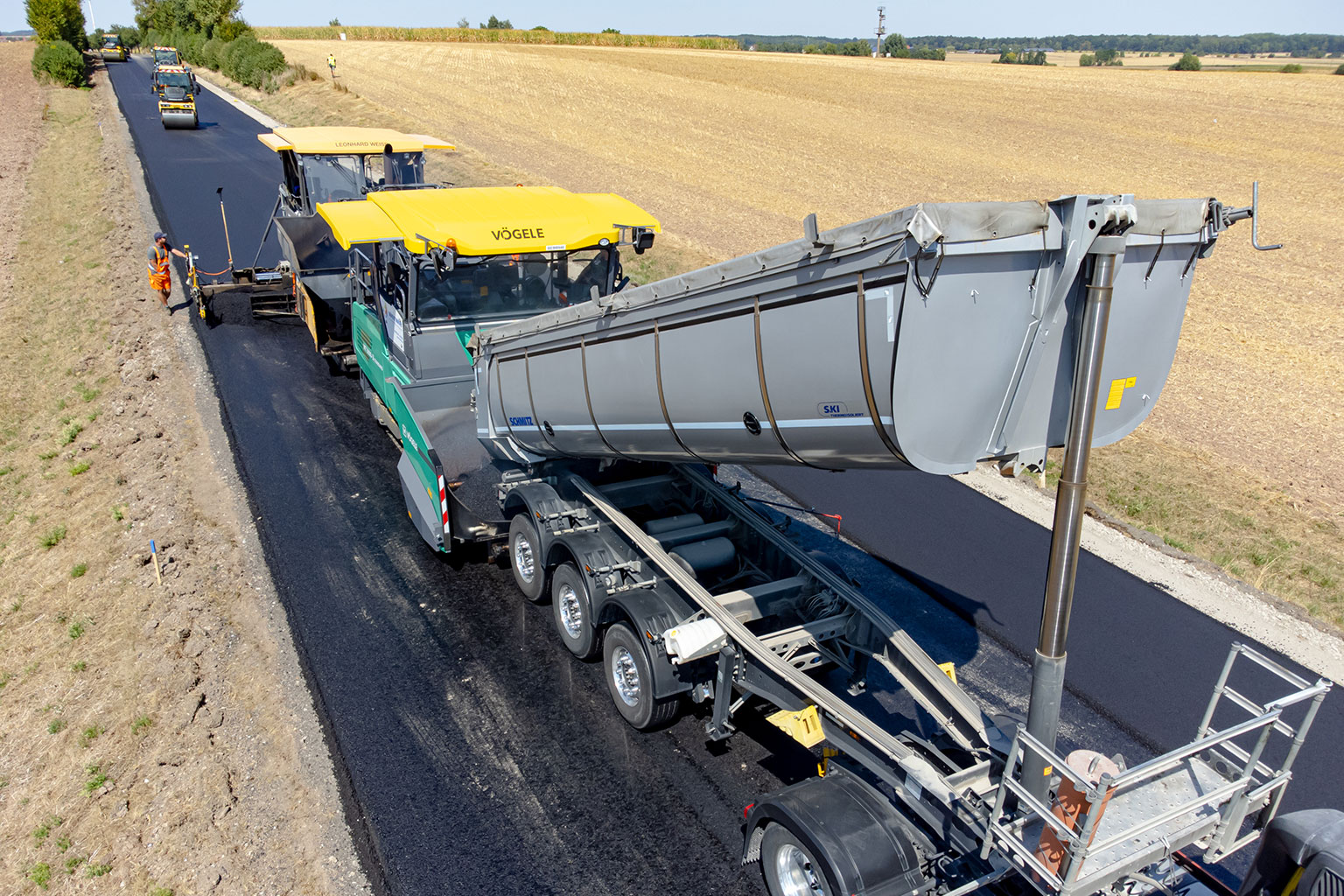

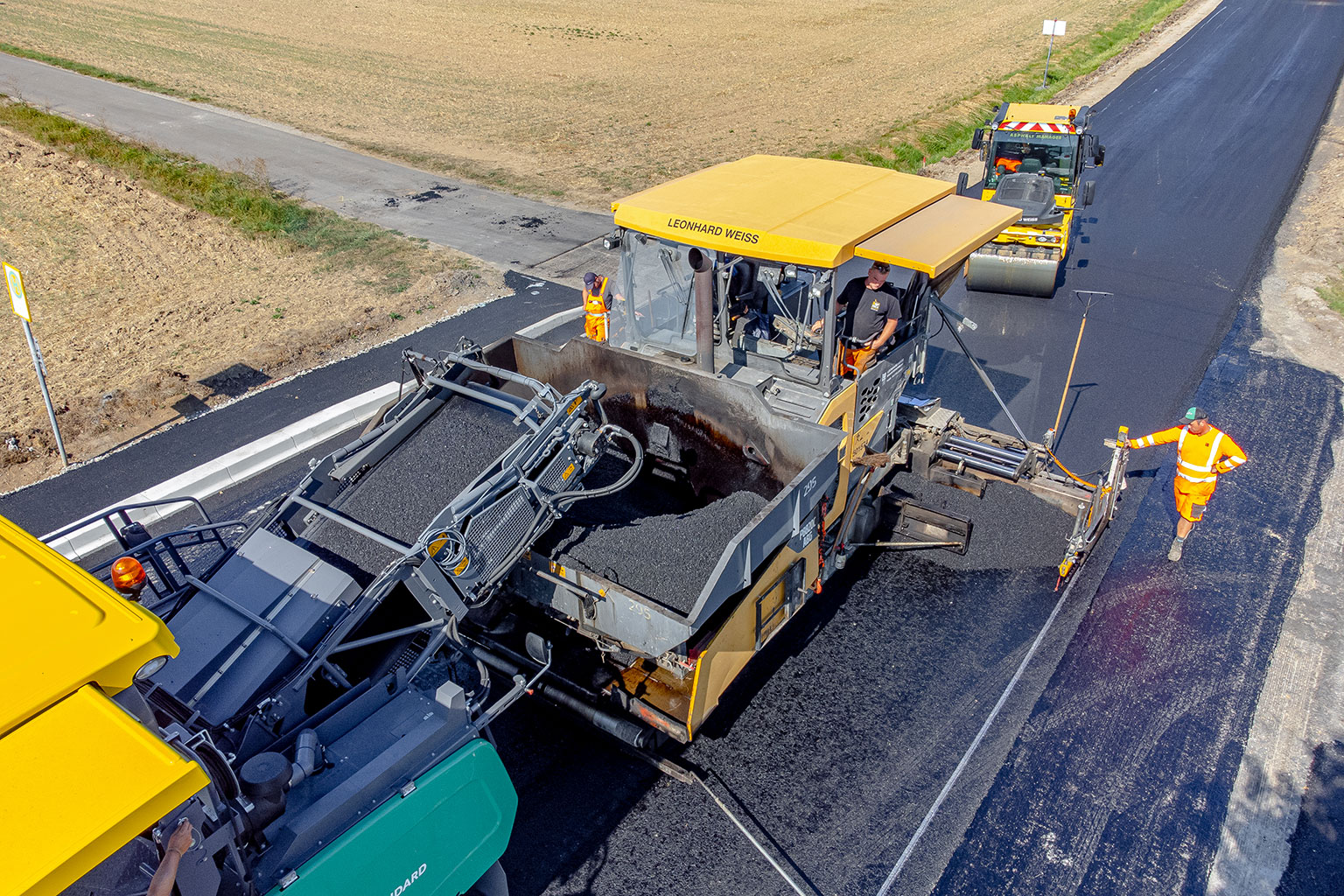

B 290 renovation of road surface Wallhausen – Rot am See

Customer:Regional Commission Stuttgart
Construction period: 5 weeks Year of construction: 2022


Large-scale deviation signs for the complete shutdown of the federal road B290
Renovation of 4 channelising islands with glued kerbs
Renovation of 4 bus stops with special kerbs
Installation of a transverse channel StB DN 1000 under the federal road B290
Removal and new installation of 330 m kerbstones
Milling of asphalt layers 31,000 m²
Milling of asphalt base course 6,000 m²
Production of asphalt base course 1,400 t
Production of asphalt binder layer 6,900 t
Production of asphalt surface layer 31,000 m²
Stabilisation of shoulder 5,800 m
Production of road marking 11,000 m

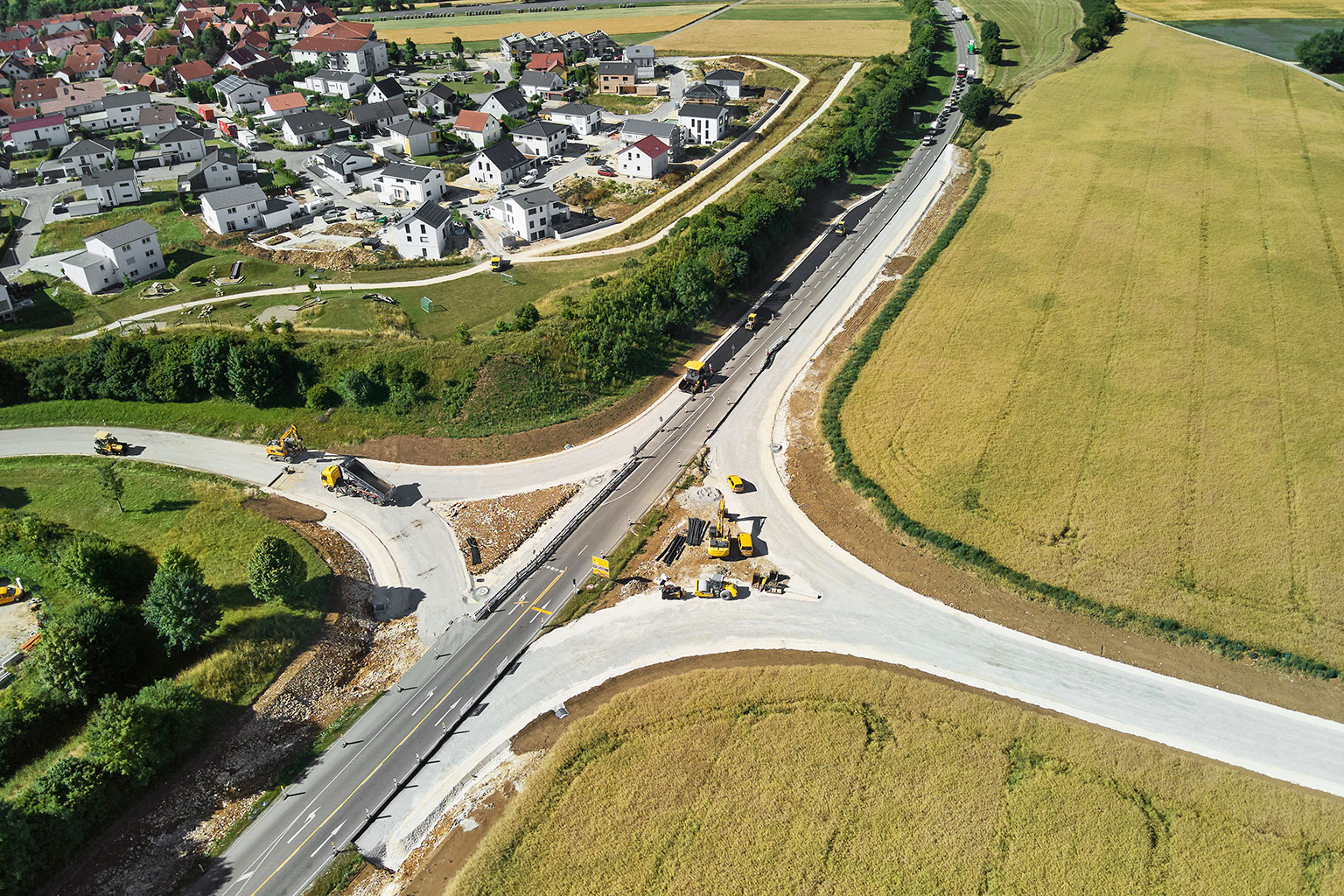

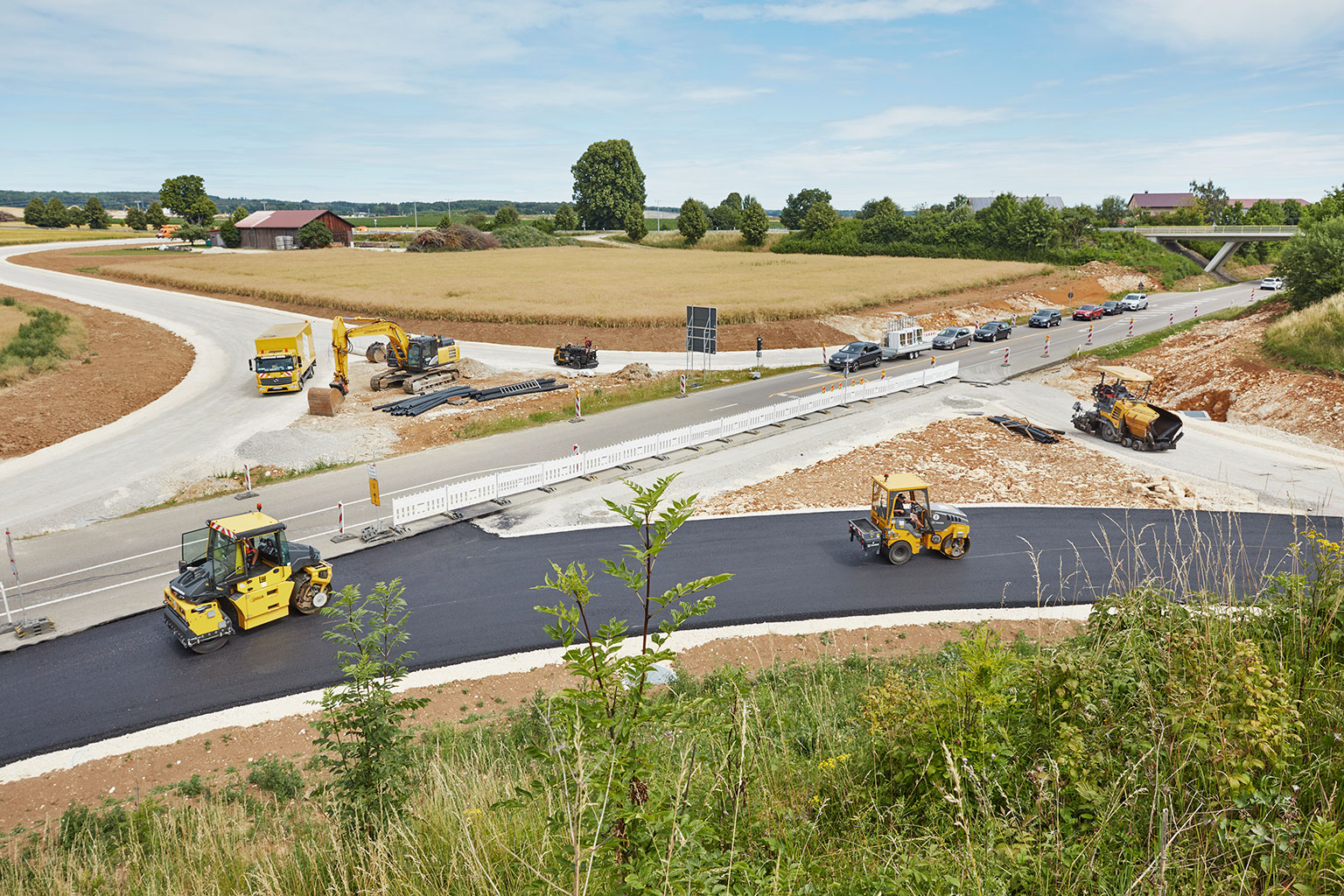

Upgrade of junction L 1230 / L 1234 / K 7407 in Merklingen and asphalt works L 1230 Machtolsheim-Merklingen

Customer: Verband Region Schwäbische Alb
Construction period: 7 months Year of construction: 2022
6 traffic phases for the production of connections
Earthworks 12,500 m³, 4,500 m² of the earthworks was rock processed for reuse
3,000 m² laying of clay sealing sheeting according to RiStWag
12,500 t ballast material
7,530 t asphalt base courses

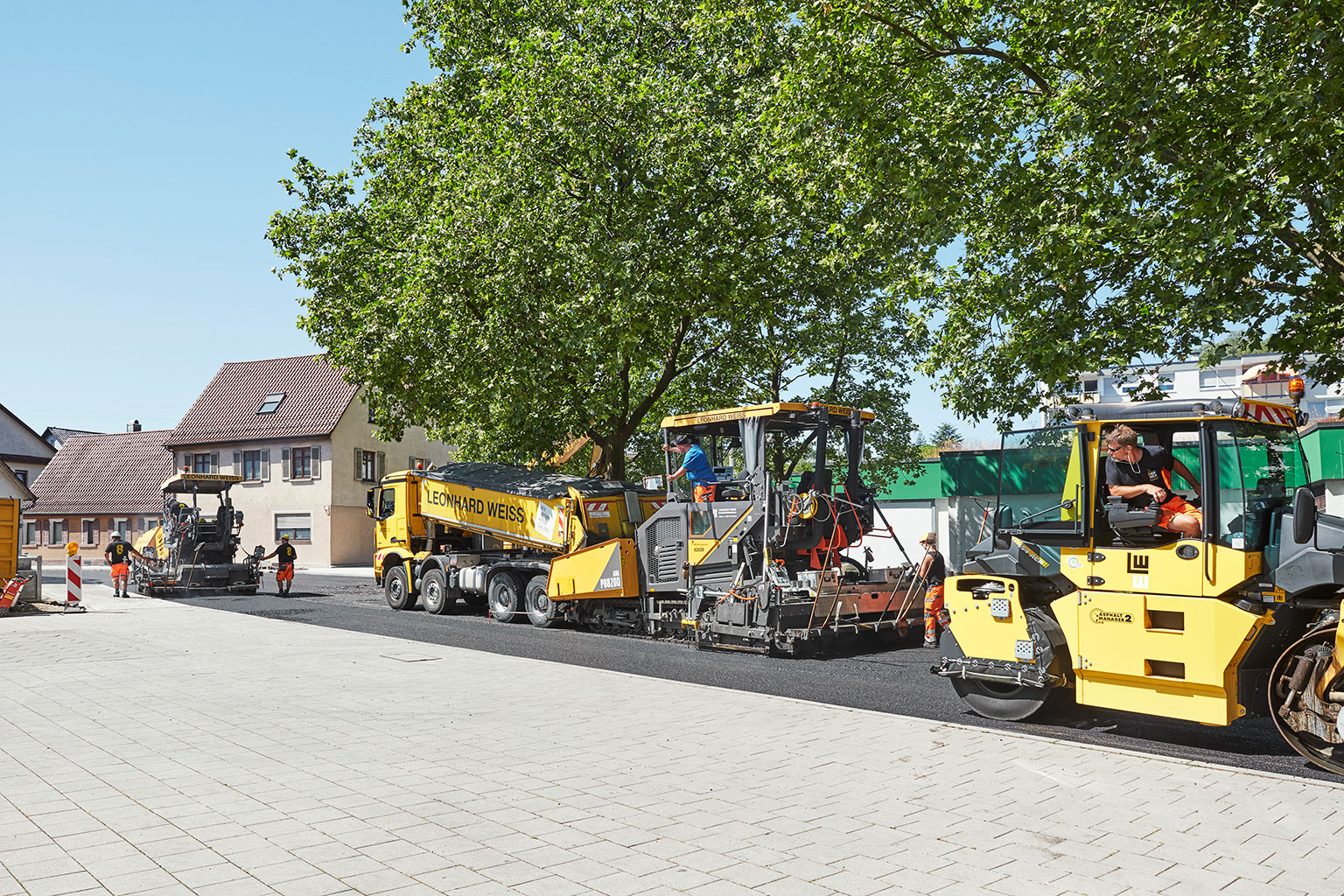

Main through-road Göppingen-Holzheim

Construction phase 3 renovation of Schlater Straße

Customer: City of Göppingen
Construction period: 6 months Year of construction: 2022
3,800 m² removal of asphalt
1,500 m renovation of shoulders made of granite
970 m² new construction of paved surfaces
300 t asphalt surface layer SMA LA (mastic asphalt with gritting material, noise reduced)
750 t asphalt binder layer
1,200 t asphalt base course
Renovation of three bus stops

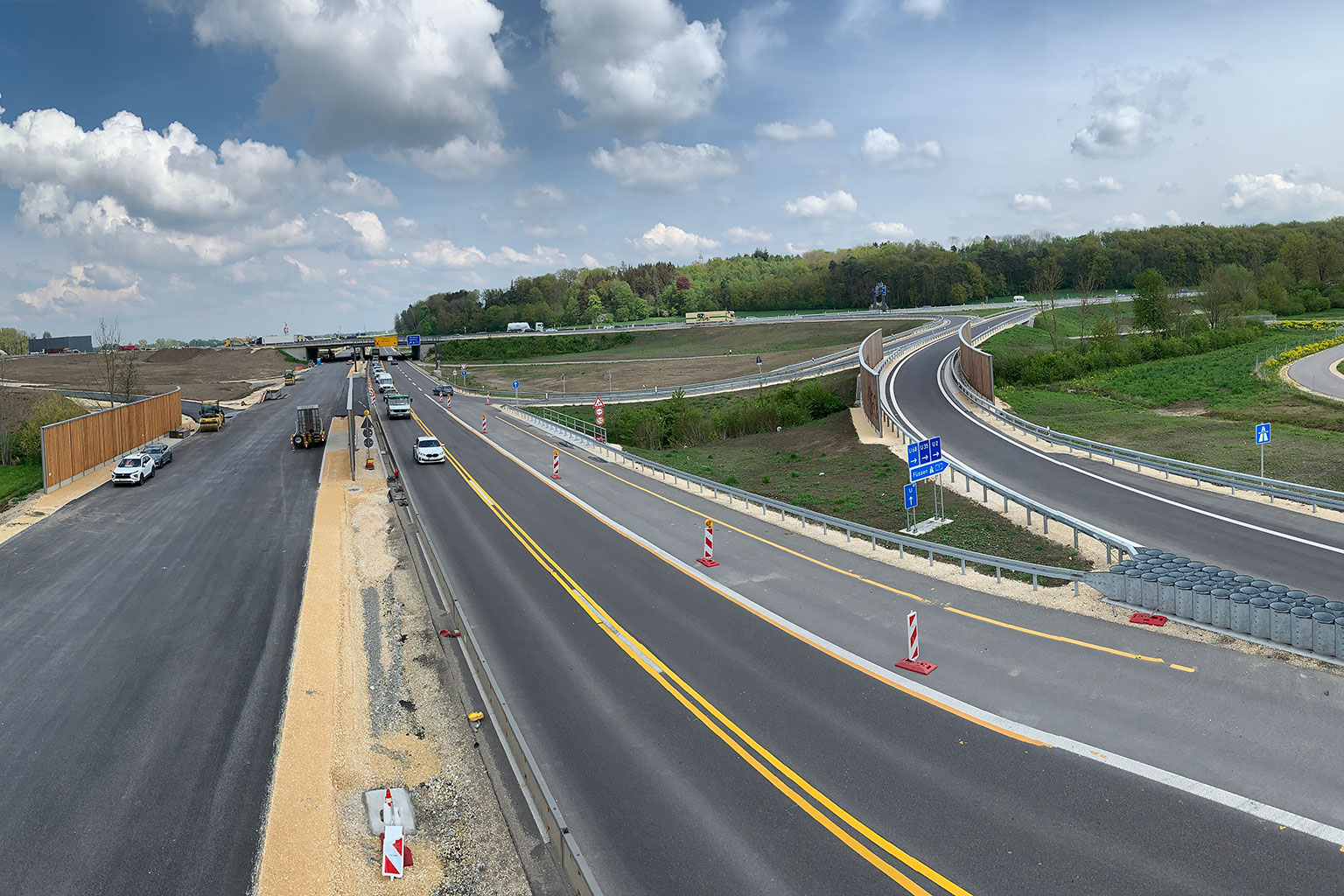

Upgrade federal road B10 Neu-Ulm/junction motorway A7 Nersingen

Customer: Staatliches Bauamt Krumbach
Construction period: 36 months Year of construction: 2019–2022
75,000 m² topsoil works
55,000 m² dislodging of soil
35,000 m³ gravel-sand-material for filling up the lake
330,000 t delivery of hazardous material (Z0–Z2)
Over 10,000 t binding agent for soil improvement
210,000 t antifreeze protection layer
140,000 m² main road surface federal road B 10
Installation by means of a large finishing machine with a max. width of 13.30 m
15,000 m² junction ramps motorway A7
11,000 m² surface construction St2021
10,000 m² junction ramps St2021
35,000 m² bicycle paths and agricultural roads
60 pcs. concrete chutes
1,400 m reinforced concrete pipes DN 300 – DN 1000
6,500 m seepage water drainpipe
3 x demolition of bridge
2 x new construction of bridge
3 x passages in corrugated steel
1 x bridge renovation
275 m noise protection wall
200 m irritation protection wall
80 m gabion wall

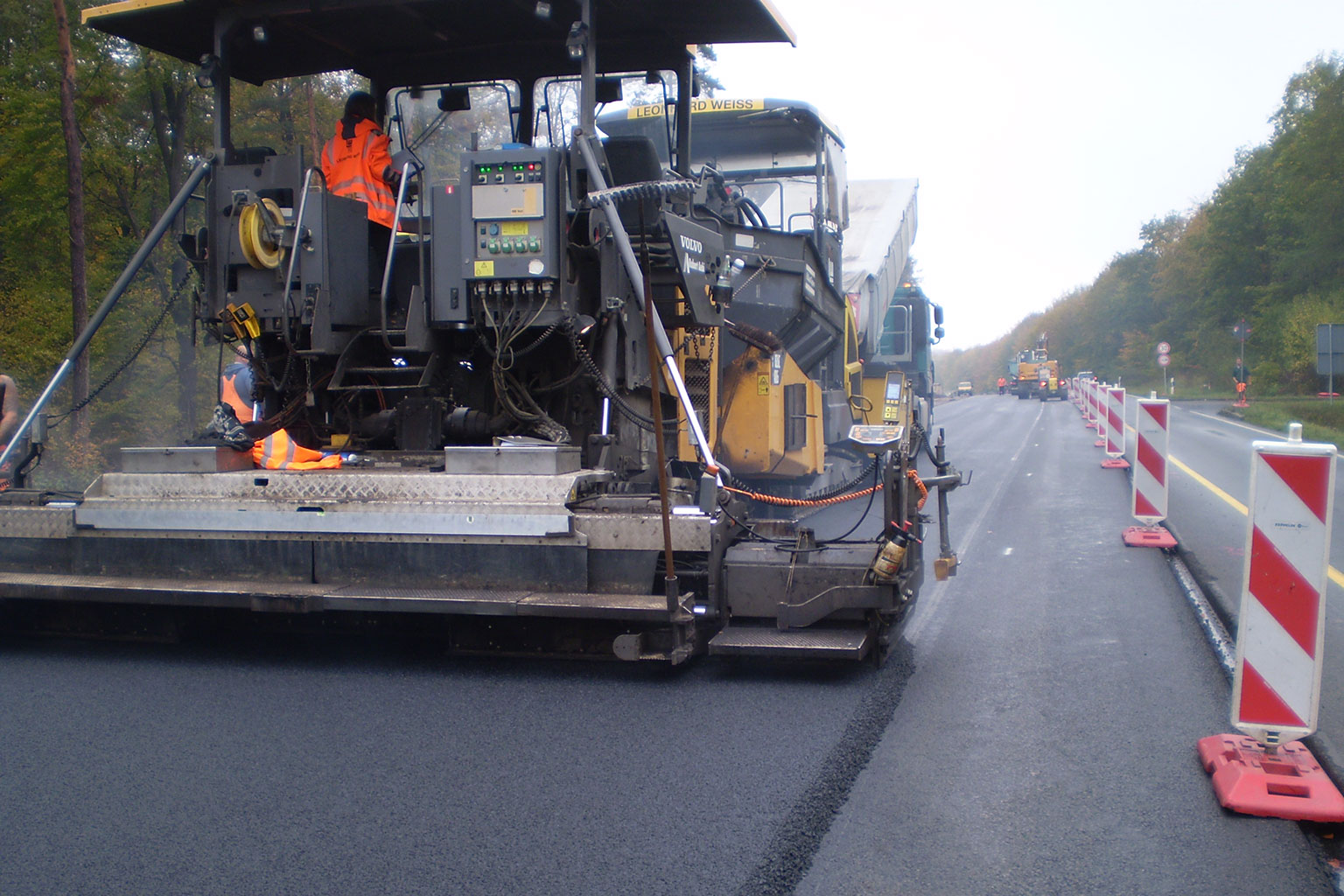

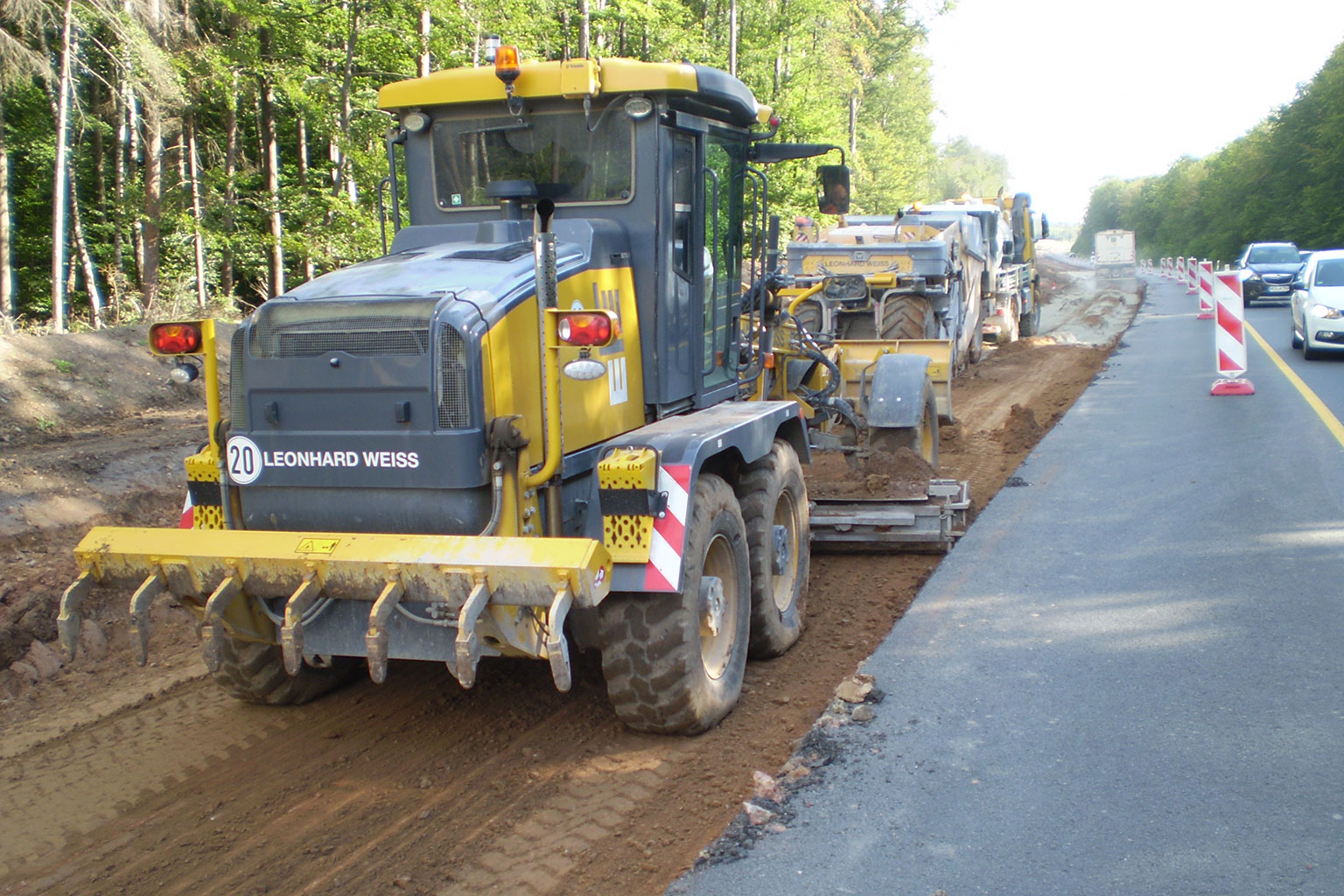

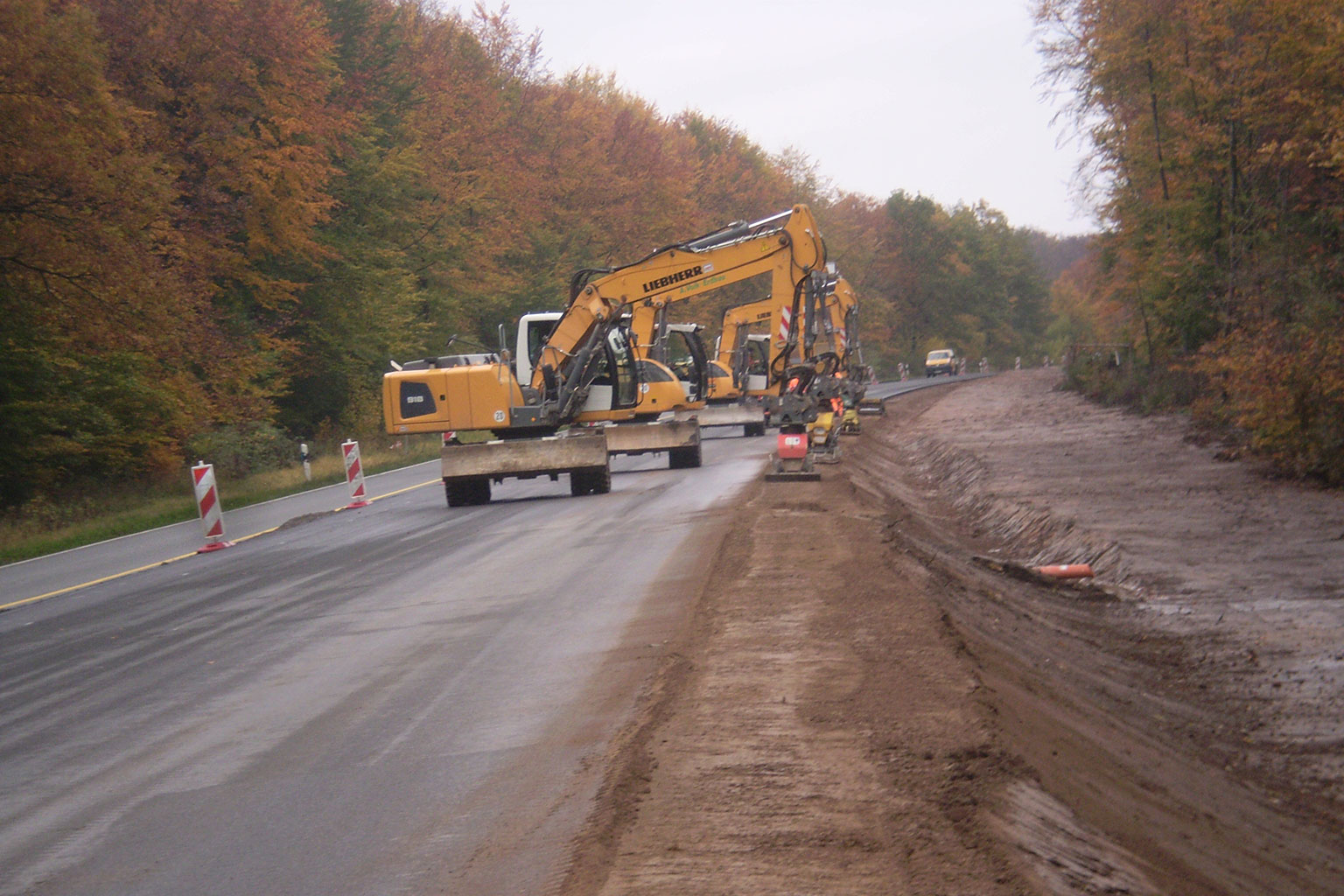

Federal road B 27, three-lane upgrade between country road L 523 and Buchen Süd

Customer: Regional Commission Heidelberg Bauleitung Buchen
Construction period: 6 months Year of construction: 2020
10,000 m³ installation of topsoil
13,000 m³ earthworks
30,000 m² formation
11,000 m³ antifreeze protection
41,000 m² asphalt

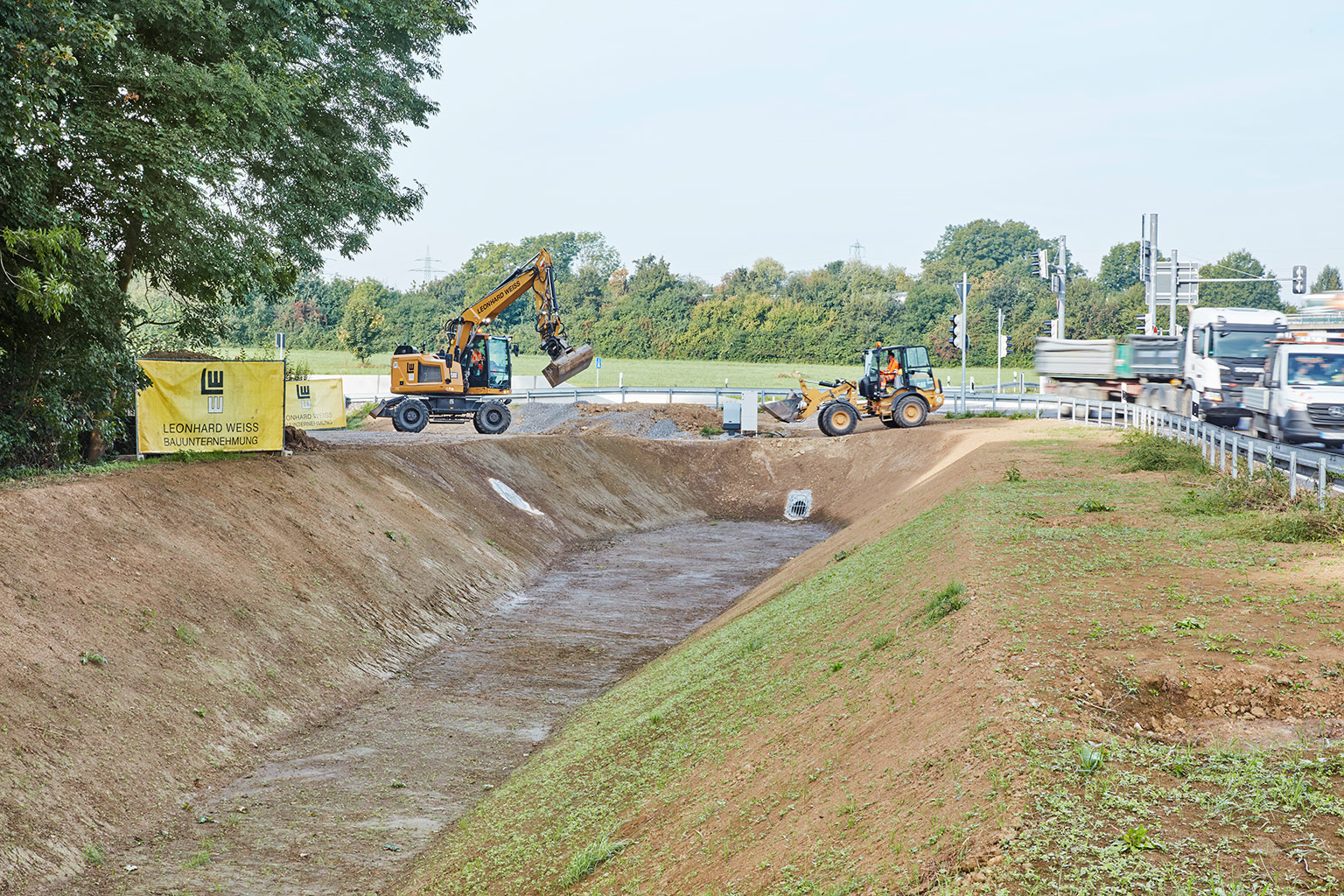

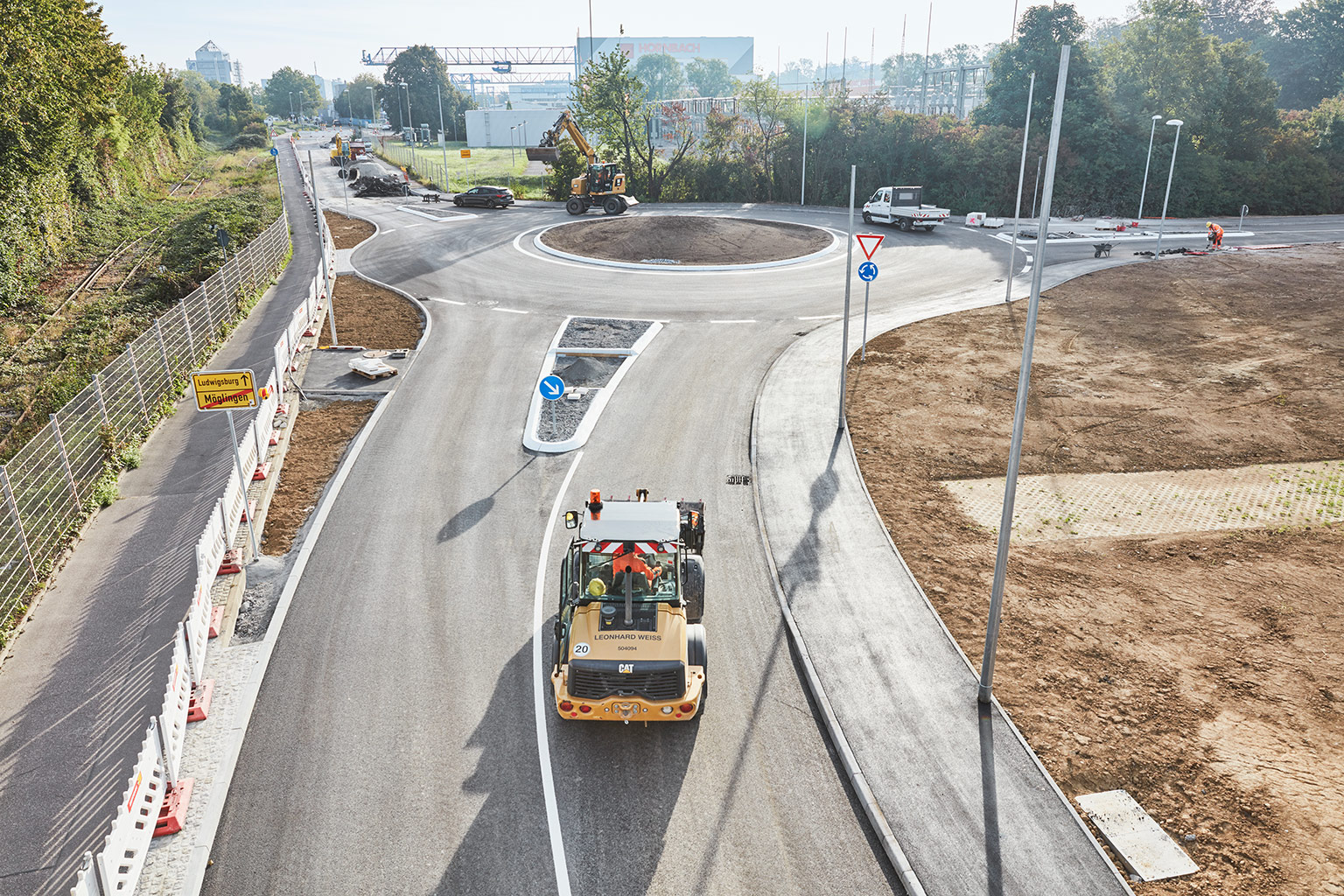

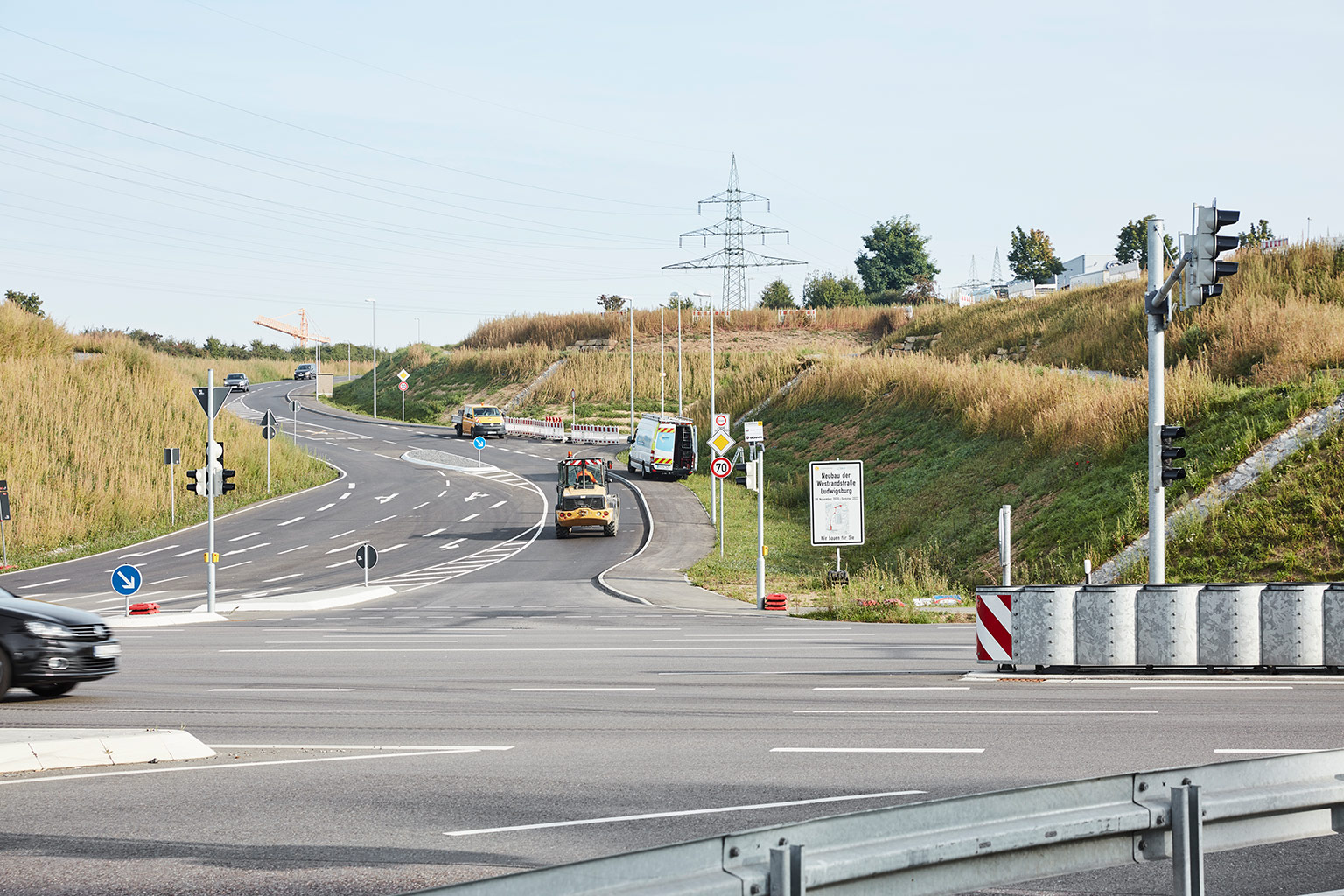

Western bypass of Ludwigsburg section south

Customer: City of Ludwigsburg
Construction period: 14 months Year of construction: 2020–2021
Upgrade and new construction of the western bypass of Ludwigsburg (Westrandstraße) for the reduction of traffic on the main roads in the city Ludwigsburg in 5 construction phases.
Roadcut in the terrain with 30,000 m³ excavation of soil
Embankments with 4,500 m² erosion protection mats
New construction of 2 roundabout traffics
Construction of a rainwater retention basin
Bituminously bound superstructure 8,000 m²
Additionally, road surface renovation asphalt 7,000 m²
Production of frost control and ballast base course 10,000 t
Drainage channel DN 300 300 m

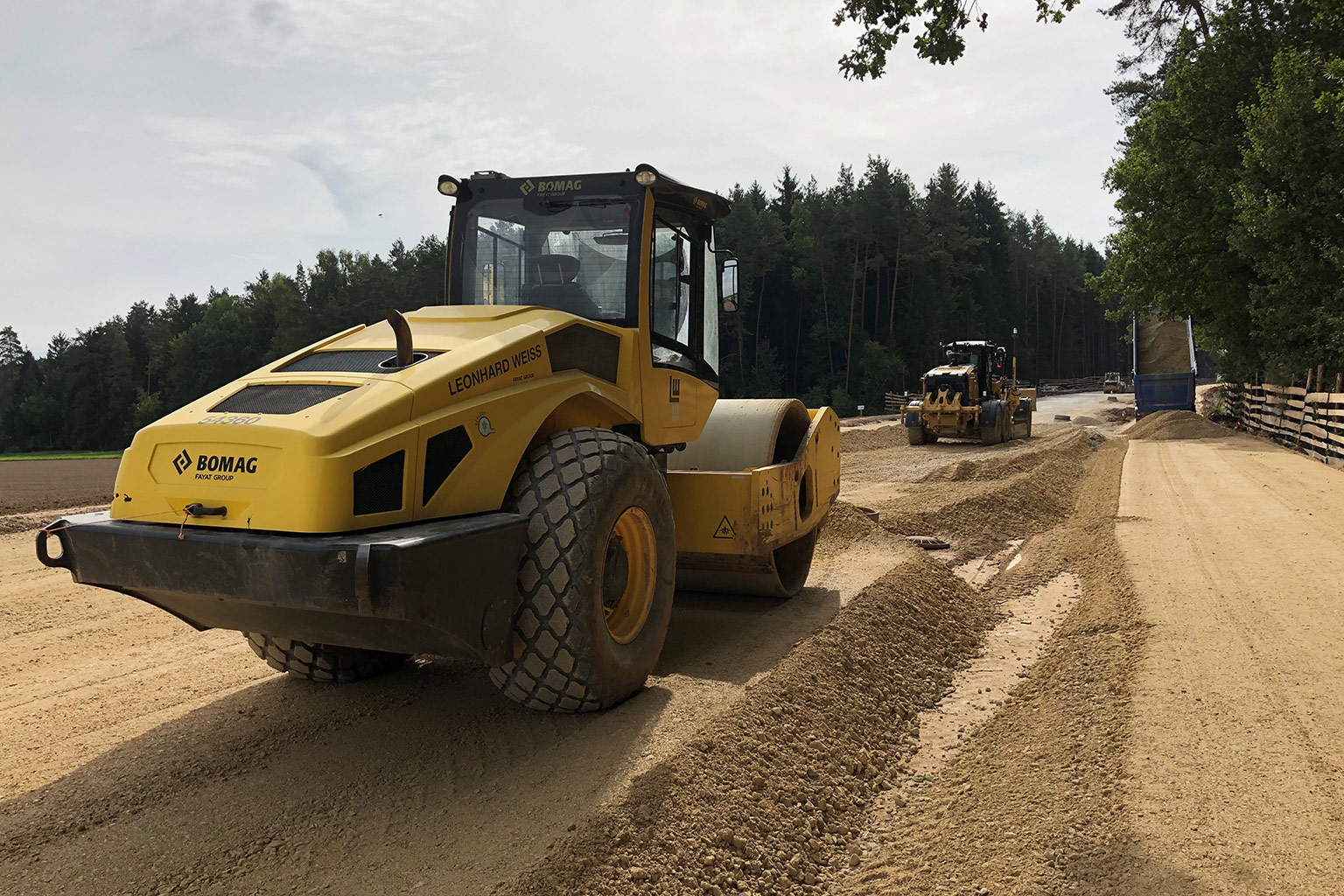

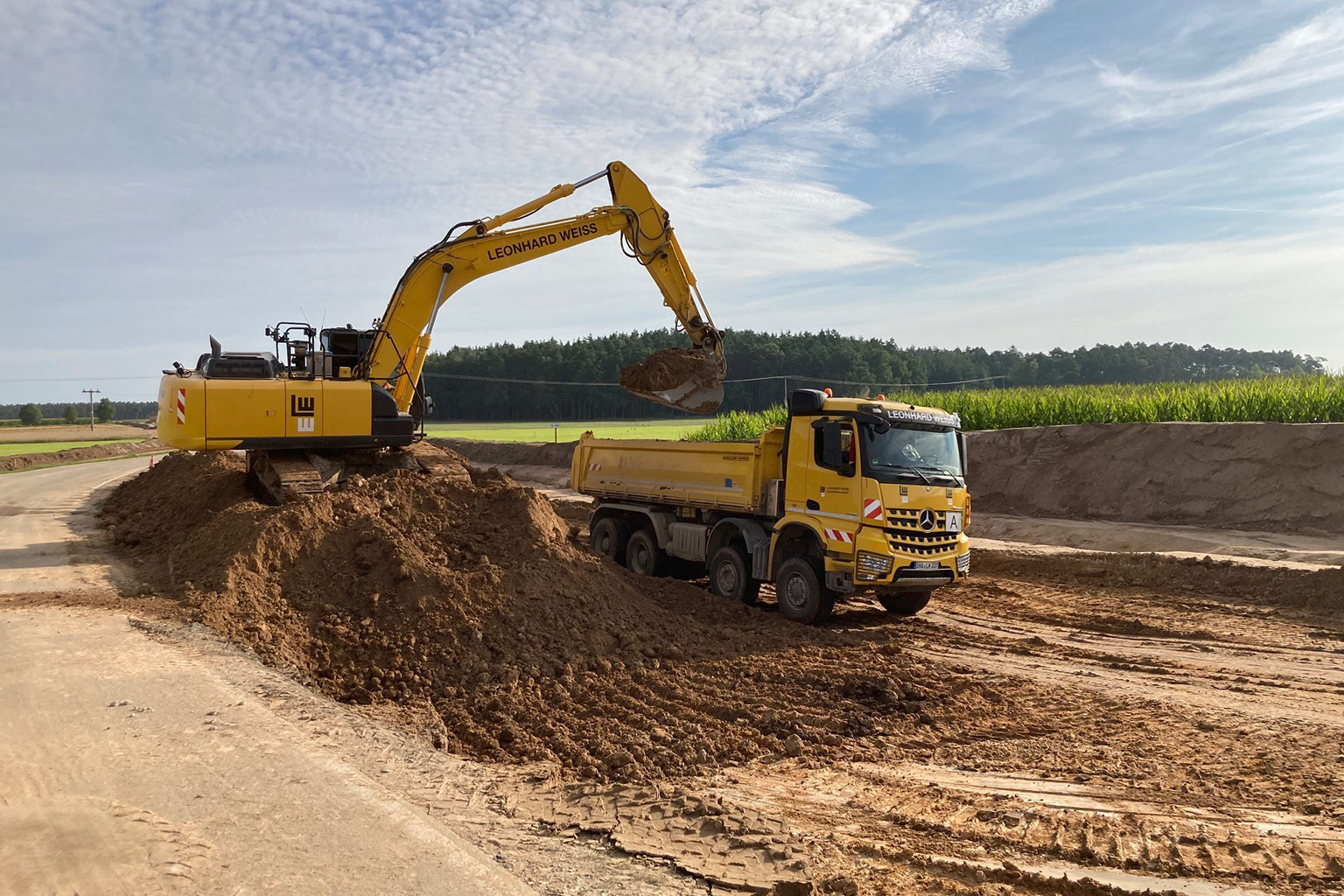

Upgrade of road St 2248 Häuslingen – Wieseth BA II

Upgrade of the road St 2248 with new construction of a pedestrian and bicycle path, section Häuslingen - Wieseth

Customer: Federal construction office Ansbach
Construction period: 4 months Year of construction: 2021
Complete upgrade on a length of 1.4 km and road surface refurbishing on a stretch of 0.5 km
Removal and reinstallation of approx. 11.000 m³ topsoil
Earth movements of approx. 15,000 m³ soil
Soil improvement measures on a surface of approx. 20,000 m²
Milling and disposal of tarry existing asphalt surface
Delivery and installation of approx. 20,000 t ballast base course
New construction of a 2-layer asphalt surface on the approx. 10,000 m² large road surface
New construction of a 2-layer asphalt surface on the approx. 4,500 m² large pedestrian and bicycle path surface
Road surface refurbishing of the approx. 3,000 m² large main trough-road of Häuslingen
New construction of approx. 500 m channel pipe (300 m armoured concrete pipes and 200 m plastic pipes)
New construction of approx. 1,100 m seepage pipe
