    Connecting reliable
    transport channels
    Track construction

Temporary bridges

It is essential to minimize disturbances when carrying out maintenance and repair work on railway networks. Temporary bridges are installed for trains to continue running along their designated tracks when constructing railway bridges without affecting normal operation. Culverts, roads, paths or even entire bridges can be constructed under these temporary bridges. LEONHARD WEISS can supply everything you need from one single source when installing and disassembling temporary bridges.

Transport of temporary bridges
Installation using their own front rail hoisting cranes (GS 150.17 TR or KRC 1200UIC)
Installation from lateral storage using truck cranes
Installation of temporary bridges in tandem
Welding on supports
Upkeep of the temporary bridge during Construction period
All measuring work on the rail and temporary blip, including documentation

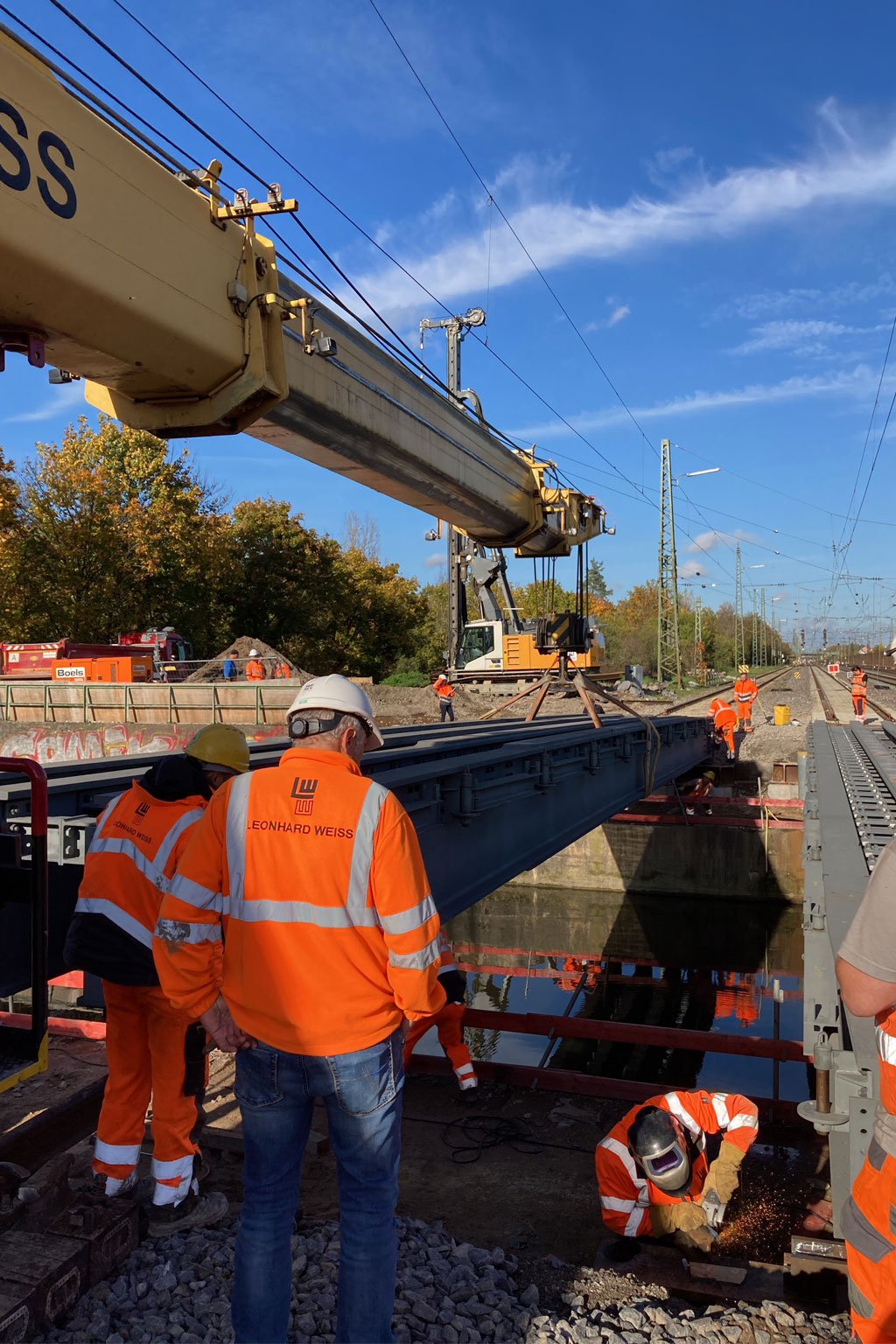

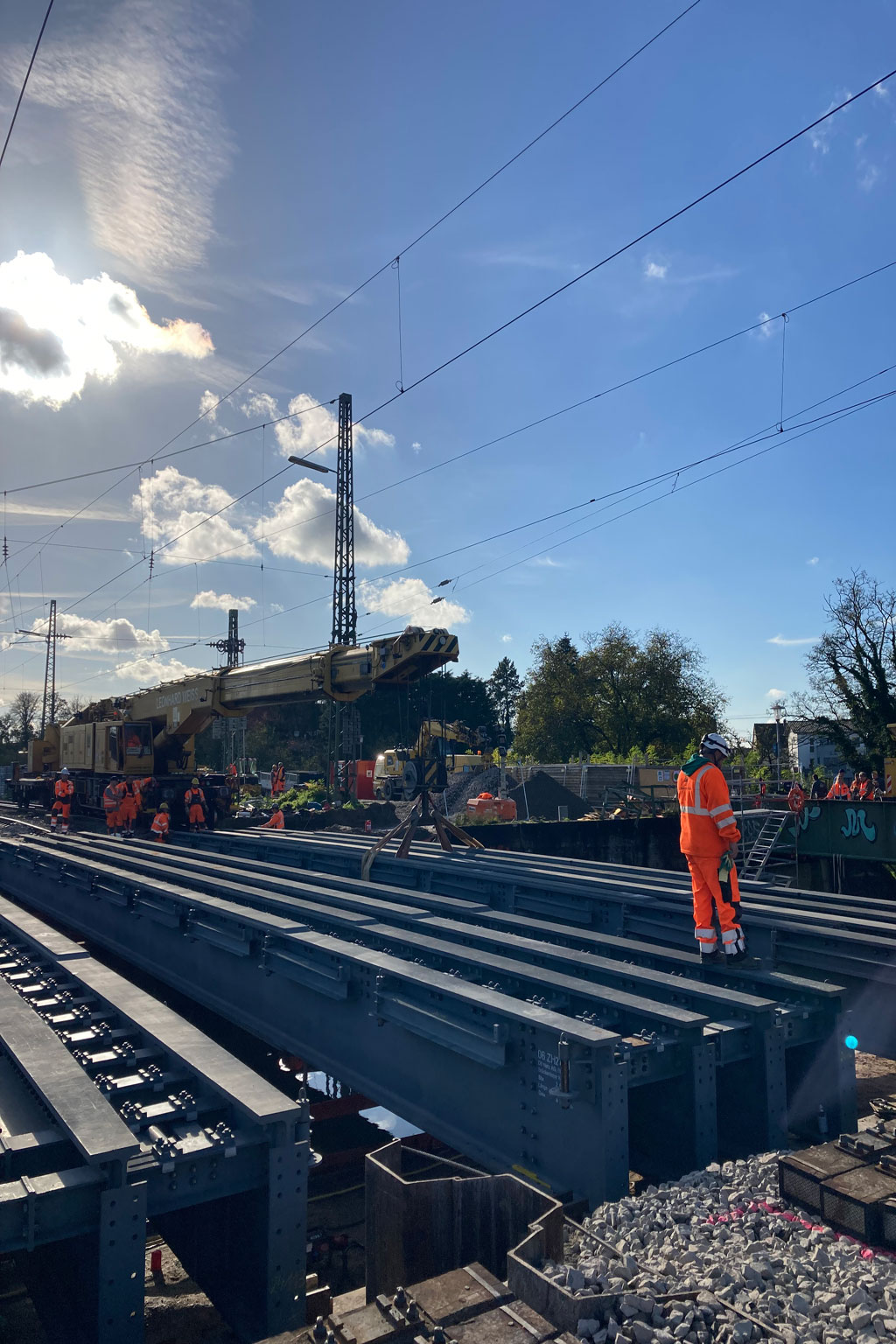

Railway bridge Saalbachkanal Graben-Neudorf

Customer: DB Netz AG
Construction period: 28 months Year of construction: 2022–2024
Delivery with road logistics and installation of 2 auxiliary bridges ZH 24 (weight up to 60 t each) in June 2022
Delivery with railway logistics and installation of 3 auxiliary bridges ZH 24 (weight up to 60 t each) in November 2022
Track dismantling incl. complete excavation before the upgrade of the existing bridge 5 x 50 m
Track construction incl. complete renovation of track bed over new auxiliary bridges 5 x 50 m
Construction-temporal dismantling of existing point incl. closing of gap
Construction-temporal relocation of the existing point incl. reinstallation

Railway flyover Söllingen

Customer: Albtal-Verkehrs-Gesellschaft mbH
Construction period: 20 months Year of construction: 2022–2023
Delivery and removal of the auxiliary bridge per heavy-load truck HB-ZH24 Length = 24 m Weight = 54 t
Installation and deinstallation of the auxiliary bridge by means of a railway crane
Superstructure works for installation and deinstallation of the auxiliary bridge

Railway overbridge Wertach

Customer: DB Netz AG
Construction period: 7 months Year of construction: 2021
Track dismantling for installation of auxiliary bridges
Installation of 2 auxiliary bridges ZH07 with a span of 7.20 m
Delivery and installation of supporting beams and elastomer support
Work on superstructure after push-in of bridge
1,500 m work through tamping

Railway overbridge Ditzingen

Customer: WOLFF & MÜLLER, DB Netz AG
Construction period: 7 months Year of construction: 2021–2022
Track dismantling for installation of auxiliary bridges
Installation of 2 auxiliary bridges ZH 26 with a span of 26.40 m
Delivery and installation of supporting beams, as well as the hydraulic articulated sliding bearings
New construction of tracks on new bridge 2 x 36 m
Underground cable engineering 600 m
Lifting into position by means of mobile crane

Renovation stopping station Stetten-Beinstein

Customer: DB AG Stuttgart
Construction period: 12 months Year of construction: 2019 / 2020
Superstructure works like track dismantling and construction (2 x 25 m)
soil stabilisation (160 m³)
installation of 2 auxiliary bridges ZH 9 with shallow foundations (dismantling November 2020)
tamping works
welding works (8 pcs.)
platform edges and renovation of foundations
conversion areas 2 x 25 m

Renovation railway overbridge Auweg, train station Günzburg

Efficient track construction for new construction of railway overbridge

Customer: Vitus Rieder, Bissingen
Construction period: August 2019–December 2020 in various construction phases
Dismantling and installation of tracks and points in various construction phases for site clearance for the renovation of the railway overbridge “Auweg“
Installation of 4 auxiliary bridges, each with 9.60 m effective span, weight 15 t
Renovation of approx. 300 m track
Dismantling and installation incl. partial renovation of 3 points
New construction of 40 m platform incl. underground cable engineering and drainage

Renovation Pegnitztal bridges, Velden

Conversion works on 3 railway overbridges: Artelshofen, Steinbruch and Velden

Customer: Implenia Construction GmbH
Construction period: two and a half weeks complete shut down in August 2019 and August 2020
Traditional stabilisation of formation (1,450 m³)
Adaptation of gradients in existing track (634 m)
Production cycle path (30 m)
Installation percolating half-shells (201 m)
Renovation of percolating filter (191 m)

Track construction work per railway overbridge

Railway overbridge Artelshofen (2 x 40 m)
Railway overbridge Steinbruch (2 x 35 m)
Railway overbridge Velden (2 x 90 m)

Tunnel Diez

Customer: ARGE Tunnel Diez
Construction period: 2 months Year of construction: 2018 / 2020
Earth works and track construction works for the customer during the construction phase

Installation of 4 pcs auxiliary bridges with 12 shutdowns during week-ends:
2 pcs ZH24 (span: 24.54 m / total weight: 54,089 t)
2 pcs ZH31 (span: 31.74 m / total weight: 107,400 t)

Lifting in position by means of railway construction cranes
